Project D-2024: Manufacturing Drive and Bluff Boulevard

Project D-2024 will reconstruct and improve approximately 4 miles of roadway, from the intersection with US HWY 30 to 7th Avenue North. The project includes reconstructing 2 bridges, converting the roadway into a 3-lane section with added turn lanes all at major intersections, adding a roundabout at South 19th Street, interconnecting traffic signals, separating sewer and sanitary lines, and installing bio-swales to capture rainwater and filter storm water. It will also upgrade traffic signals, install sidewalks and a bicycle route, add transit shelters, and modify intersections.

Manufacturing Drive Map

Manufacturing Drive Map

This map shows the timeframe each phase of Project D-2024 will take place.

Phase 1 Timeframes
Stage 1AMay 5, 2025 - June 30, 2025
Stage 1BFebruary 24, 2025 - August 27, 2025
Stage 1CMarch 11, 2025- October 16, 2025
Stage 1DMarch 11, 2025 - October 16, 2025
Stage 1EAugust 24, 2025 - January 4, 2026


Phase 2 & 3 Timeframes
Stage 2AOctober 20, 2025 - June 16, 2026
Stage 2BJune 17, 2026 - November 11, 2026
Stage 2CDecember 15, 2025 - July 9, 2026
Stage 2DJune 16, 2026 - September 1, 2026
Stage 3AApril 7, 2026 - April 21, 2026
Stage 3B April 2, 2026 - July 1, 2026

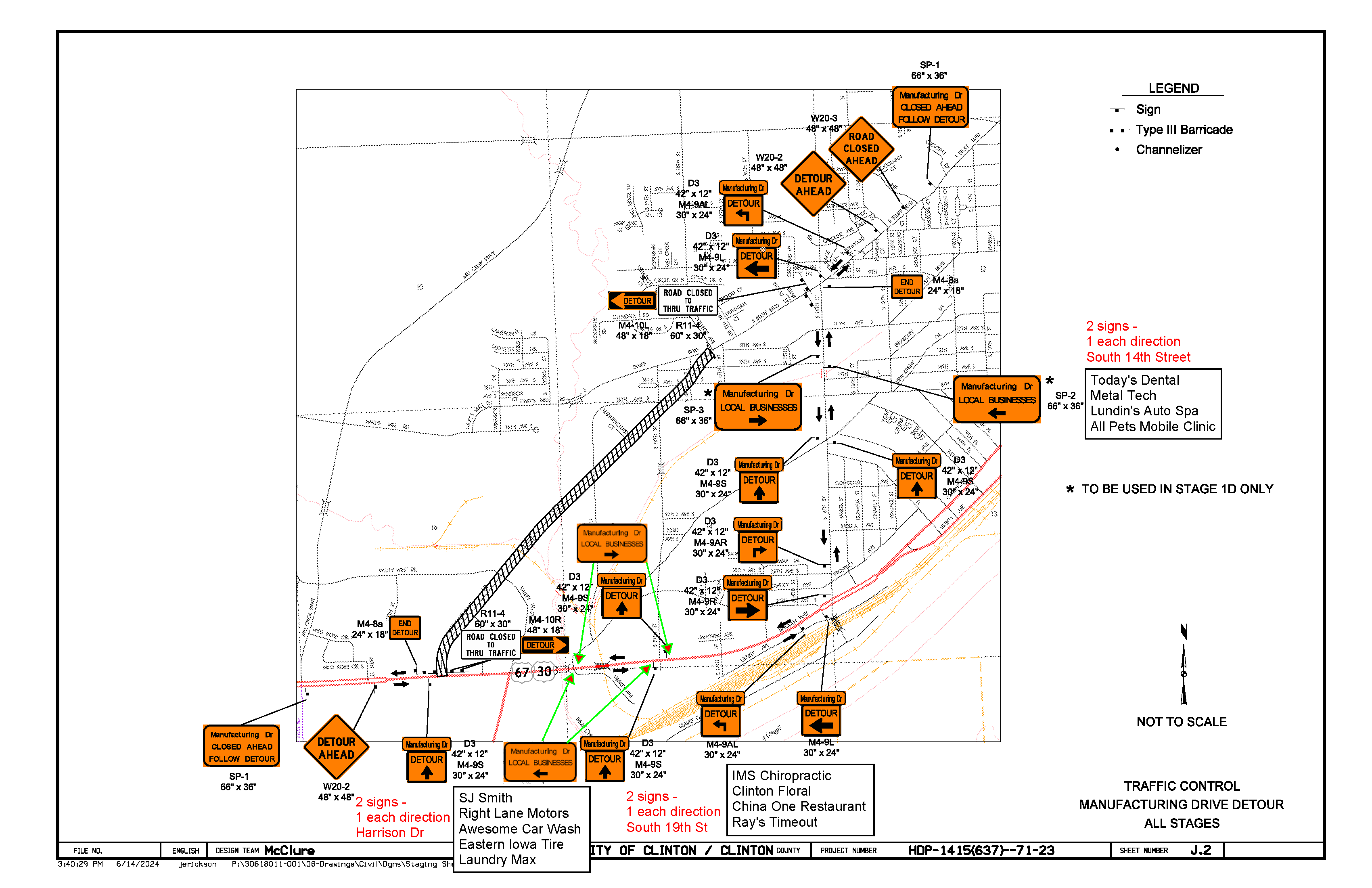

This map shows all the detours that will occur during Manufacturing Drive Road Work

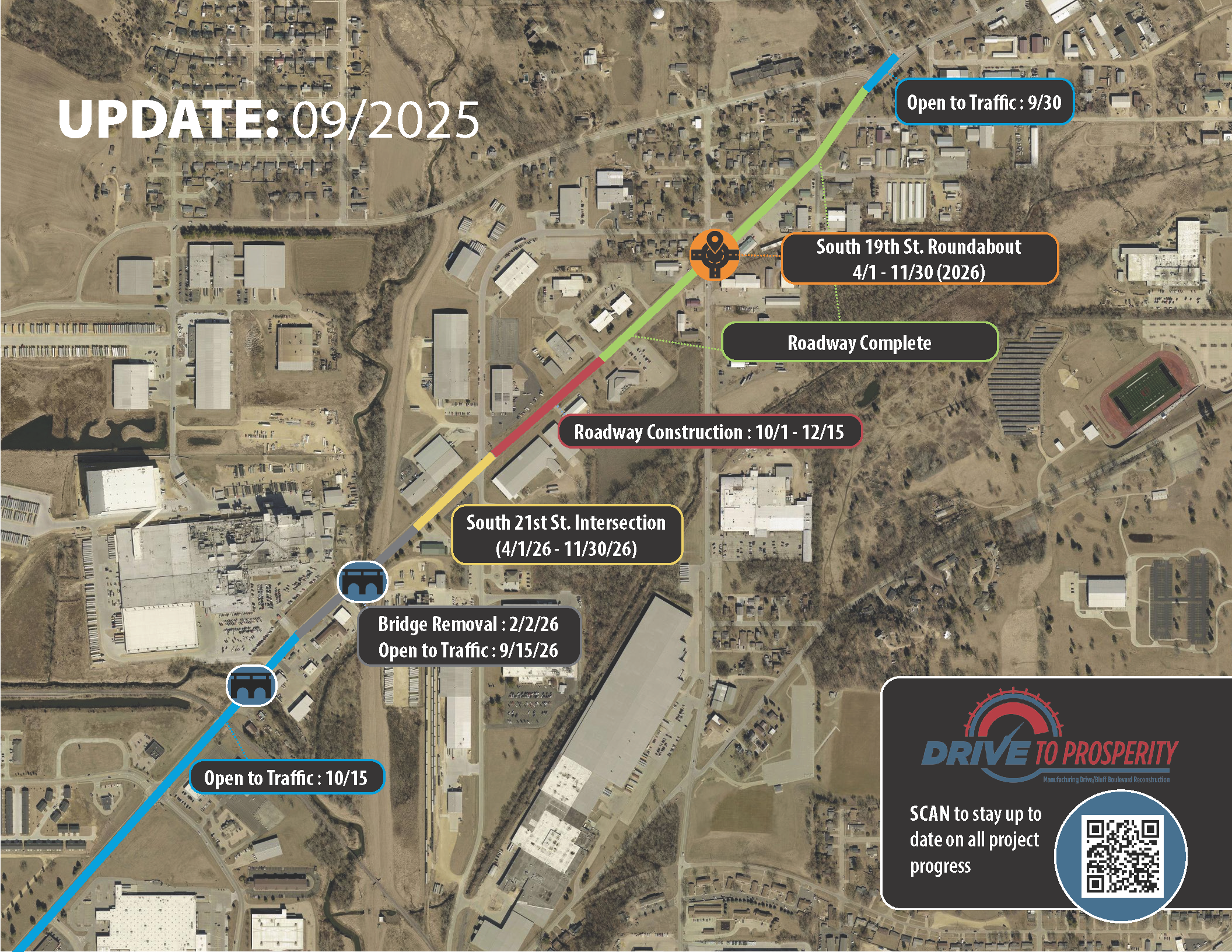

This map shows an update to the Manufacturing Drive Schedule showing construction dates.

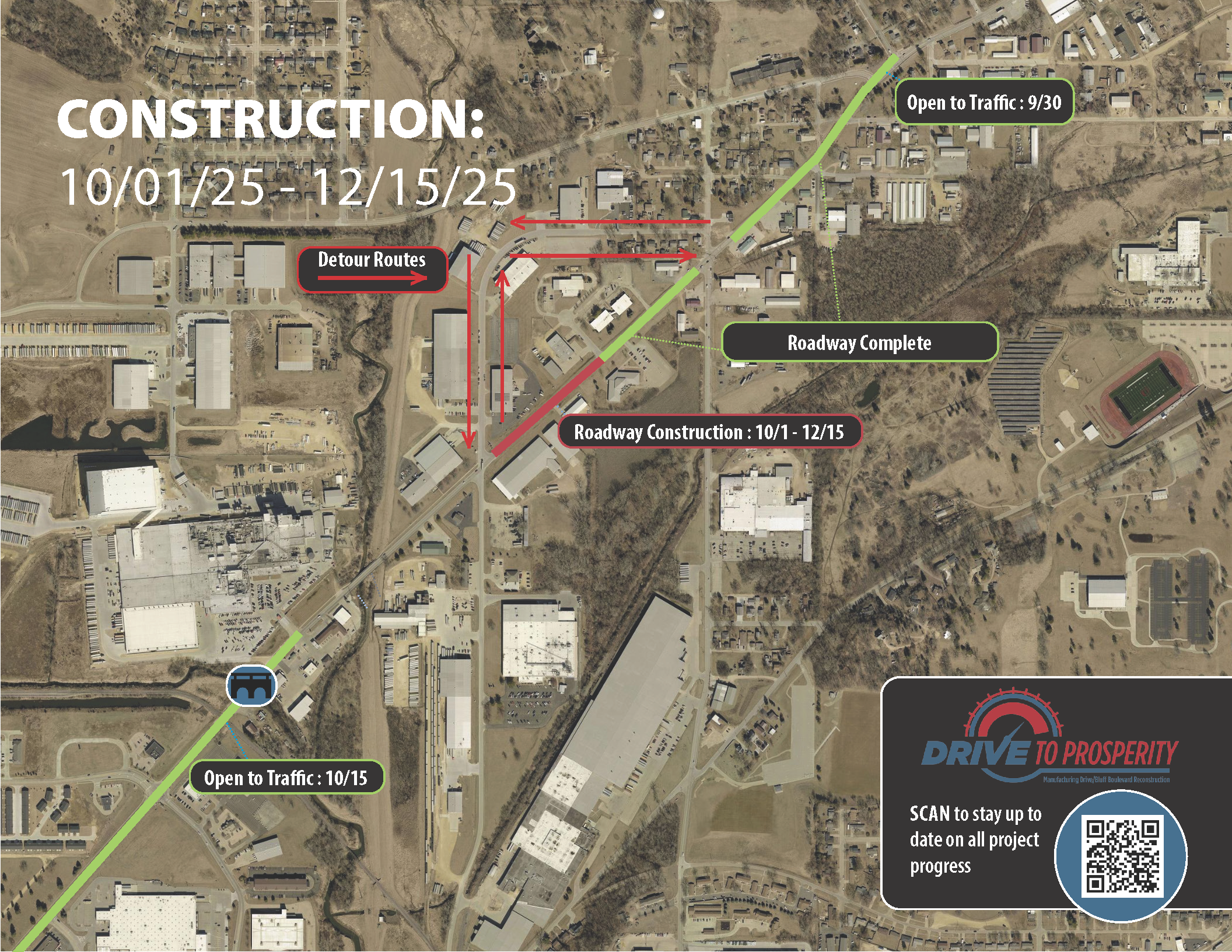

This map shows the detour for Manufacturing Drive for October 1, 2025 - December 15, 2025.

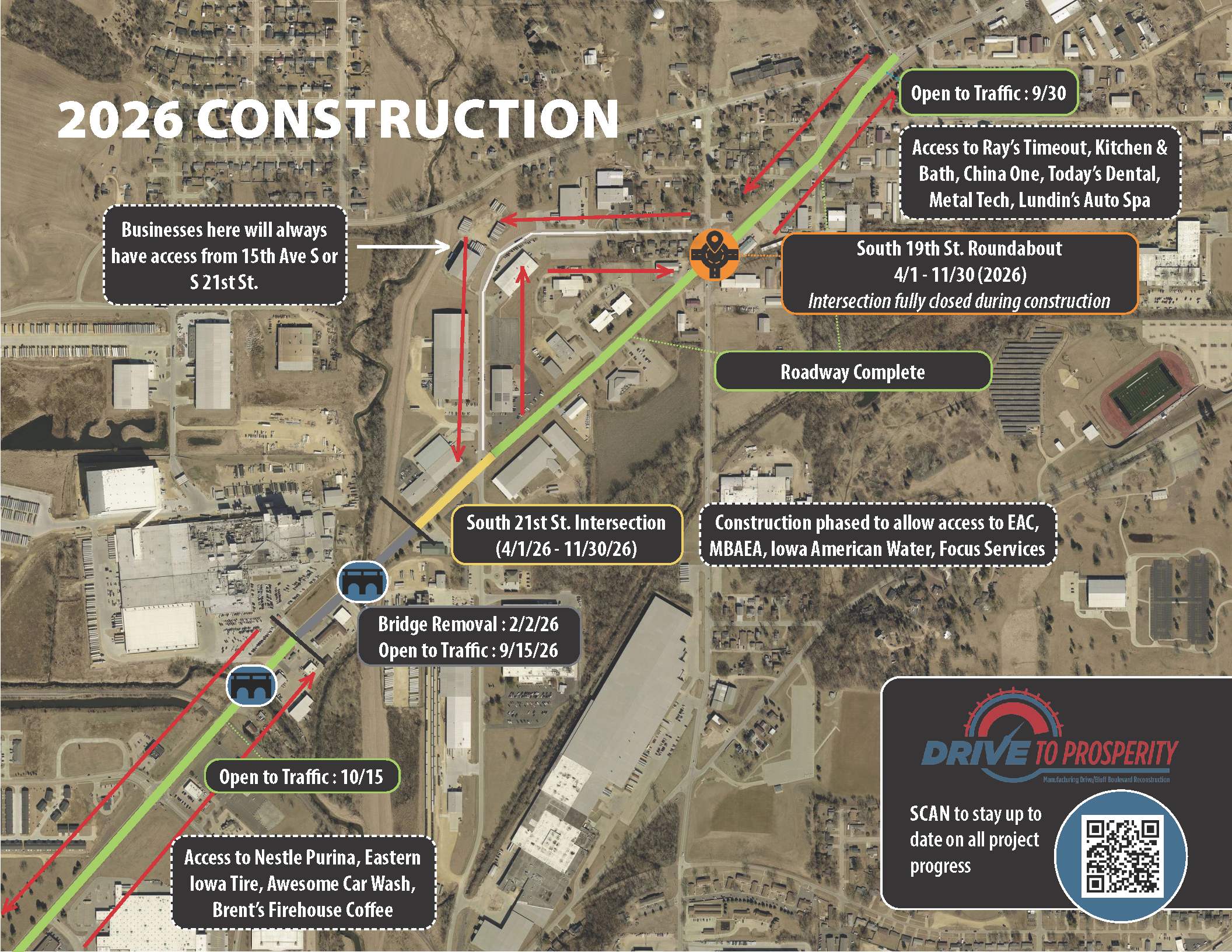

This map shows the planned construction for Manufacturing Drive for 2026
